An approved sample. A confirmed quotation. Packaging artwork moving toward completion.
For a buyer developing a smart pet product, these are encouraging signs.
The launch date is on the calendar, the team is preparing inventory, and production appears to be the next obvious step.
But this is also where some expensive OEM mistakes begin.
Not necessarily because someone made an obviously bad decision. Sometimes the sample really does work. The quotation really is competitive.
The production schedule really is tight. The problem is that a decision that made sense at one stage is carried into the next stage without checking whether its original assumptions still hold.
A component changes. A test remains unfinished.
A requirement is interpreted differently by the buyer and the factory.
Production starts because the launch date is approaching, even though an important question remains open.
Individually, these decisions can seem manageable.
Together, they can turn a promising development project into rework, delays, inconsistent products, or an argument about who should pay.
As a smart pet product OEM/ODM manufacturer, Petrust approaches these risks from the manufacturing side. The responsibility is not simply to tell buyers to check everything.
It is to understand which decisions affect production, communicate the implications, and avoid treating an unresolved issue as though it has already been settled.
This article examines seven common OEM manufacturing mistakes, what each one can cost, and what buyers and manufacturers should establish before moving forward.
The central principle is straightforward: a product that works once is not automatically a product ready for repeatable mass production.
For buyers who are still comparing potential suppliers, execution risks are only part of the decision.
It may also be worth understanding how experienced buyers verify smart pet product manufacturers before committing to an OEM project, particularly when a supplier’s promises need to be weighed against its actual manufacturing capabilities and supporting evidence.
The Sample Passed. The Project May Still Not Be Ready.
One of the most persistent common OEM manufacturing mistakes is treating sample approval as proof that the entire project is ready for production.
Sample approval answers a specific question: did the evaluated sample meet the requirements assessed under the agreed test conditions?
Mass production readiness asks something different: can the intended production configuration be manufactured repeatedly, with the necessary materials, components, processes, software, and inspection criteria, while meeting the agreed requirements?
The distinction matters.
Consider an automatic pet feeder. A development sample dispenses food correctly. The buyer checks the appearance, tests the main functions, and approves the unit.
That approval has value. It should not be dismissed simply because the product is still in development.
But it does not automatically establish that:
- The production components match the configuration used for evaluation.
- Critical dimensions and assembly requirements are sufficiently defined.
- The intended firmware version is identifiable.
- Required functional or reliability verification has been completed.
- Production and quality teams can apply the same acceptance criteria.
- Any differences between the sample and production configuration have been reviewed.
Some projects will already have satisfactory answers to these questions. Others will not.
The important thing is to establish which situation applies instead of assuming that sample approval resolves everything.
A development sample may have been assembled with additional engineering attention, selected components, or temporary adjustments.
In another project, the sample may already closely represent the intended production configuration. Neither conclusion should be assumed without examining the actual project evidence.
| Decision area | What to establish |
|---|---|
| Approved configuration | Which specifications, drawings, components, and relevant software versions define the product? |
| Functional requirements | Which functions must work, under what conditions, and against which acceptance criteria? |
| Open engineering issues | Which unresolved items could affect safety, core functionality, manufacturability, or consistency? |
| Verification | Which required checks have been completed, and what do their results establish? |
| Release authority | Who reviews the evidence and approves the next production stage under the project agreement? |
The objective is not to create paperwork for its own sake.
It is to prevent the buyer, engineering team, purchasing team, and production line from working from different versions of what they believe has been approved.

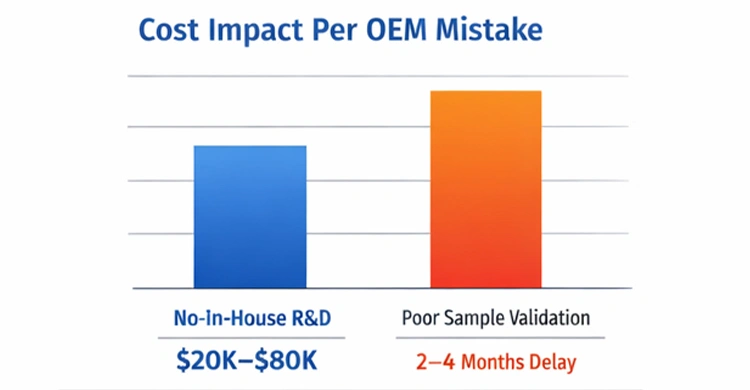

This gap between sample approval and production readiness is where a project can lose time even when the sample itself looks good.
Buyers planning their next production milestone may benefit from understanding how the OEM process moves from an approved sample to mass production, including the decisions that need to be settled before unresolved issues become production delays or rework.
Mistake #1: Treating the Approved Sample as the Production Standard
An approved sample is a reference. It is not a substitute for clear, controlled production requirements.
A physical product is the result of several connected elements: materials, components, dimensions, assembly methods, software, and the criteria used to inspect the finished unit.
If those elements are not aligned with the approved configuration, the production team may be asked to reproduce an object without having a sufficiently precise definition of what made it acceptable.
The disagreement may not become visible until finished goods behave differently from the reference sample.
Imagine a feeder that dispenses the expected portion during sample evaluation.
The appearance is approved and the agreed functional checks are passed.
Later, the team discovers that the production documentation does not clearly identify a critical dimension in the dispensing mechanism.
The issue is not necessarily that the sample was bad. It is that the successful result has not been translated into a sufficiently clear and repeatable manufacturing standard.
The buyer may expect the production team to reproduce the sample exactly.
The factory may follow the available drawing and component list.
If those two references do not describe the same configuration, both parties may believe they are following the agreement.
What buyers should request
Before authorizing production, ask the manufacturer to identify the configuration that the approval actually covers.
Depending on the product, useful references may include:
- The approved specifications and relevant drawings.
- The applicable bill of materials (BOM).
- Critical dimensions, materials, and component specifications.
- The relevant firmware or software version for connected products.
- The functional requirements and acceptance criteria.
- Any differences between the evaluated sample and intended production configuration.
These records do not all need to be complicated.
They need to be clear enough to establish what is being manufactured and which version has been approved.
For smart pet products, firmware deserves particular attention.
A hardware configuration tested with one firmware version should not automatically be assumed to behave identically after a software change that affects dispensing, sensing, connectivity, or operating logic.
The practical rule is simple: if a change affects a requirement, determine whether the original approval still applies.
A manufacturer should be able to explain the relationship between the approved reference and the production configuration.
Where a difference exists, it should be made visible and handled through the agreed review and approval process—not left for the production team to interpret.
If sample approval is approaching but the evidence behind it is still unclear, it may be worth reviewing how to verify a pet product sample before mass production.
A more deliberate verification process can help identify gaps while changes are still easier to assess, rather than discovering that the approved reference and the intended production configuration do not match after manufacturing has begun.

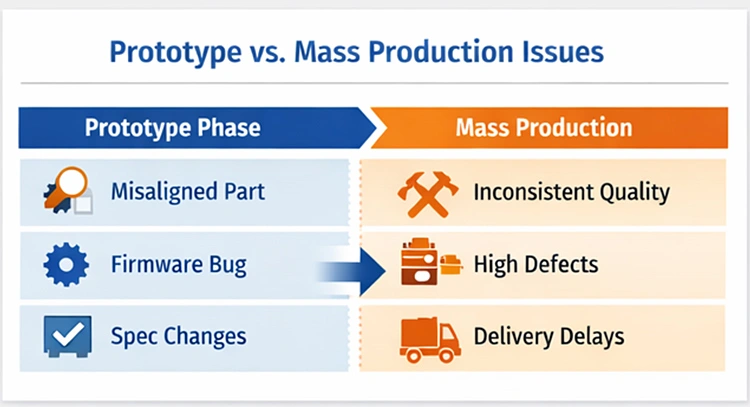

Mistake #2: Changing One Component Without Rechecking the Product
A replacement component may be cheaper, easier to source, or available sooner. It can still be the wrong change for the product.
This is where engineering judgment matters more than a purchasing spreadsheet.
A component does not operate in isolation. It interacts with other parts, the enclosure, assembly conditions, firmware, and the user’s operating environment.
A replacement that appears equivalent on paper may affect the behavior of the complete product.
Consider three examples:
- Automatic pet feeders: Changes to a dispensing component’s dimensions, material, surface characteristics, or tolerance may affect fit, friction, assembly, or food-dispensing behavior.
- Automatic litter boxes: A different motor, transmission component, or sensor mounting arrangement may affect movement or detection behavior. Physical fit alone does not establish that the existing safety or functional verification remains valid.
- Pet water fountains: A replacement pump or revised filter configuration may affect flow, noise, power consumption, or maintenance behavior.
These are examples of possible engineering effects, not claims that a particular product has experienced these failures. The point is that component compatibility must be considered within the complete system.
A supplier datasheet can establish characteristics of the component itself. It cannot, by itself, prove that the assembled product will retain all previously verified performance.
The review should answer four questions:
1. What could the change affect?
- Consider the relevant interfaces, dimensions, materials, assembly steps, product functions, firmware dependencies, and operating conditions.
2. Which previous verification results remain valid?
- Some evidence may remain applicable. Other results may need to be repeated or supplemented. The answer depends on the nature of the change and the requirements it could affect.
3. What else must be updated?
- A component change may affect the BOM, drawings, assembly instructions, test procedures, packaging, labeling, or compliance-related documentation.
4. Who approves the change and its implementation?
- The technical assessment, commercial decision, and production implementation are related but not always the same responsibility. The project should make clear who evaluates the impact, who approves the relevant change, and how the accepted version is identified.
Research on engineering change management in manufacturing supports the importance of coordinating assessment, communication, and implementation across the functions affected by a change.
A cheaper component is not necessarily a cheaper product decision. If the change requires additional testing, creates assembly difficulties, affects product performance, or raises new compliance questions, the initial saving may not survive the full evaluation.
The responsible approach is not to reject every substitution. It is to evaluate the change before it becomes an unexamined assumption in production.
Mistake #3: Rushing Mass Production Before the Evidence Is Ready
Starting production earlier does not necessarily mean delivering earlier.
This is difficult to accept when a seasonal sales window is approaching, packaging has been ordered, and internal teams are waiting for inventory. But production activity is not the same as project readiness.
When an important question remains unresolved, starting a large production run may move that uncertainty into material purchasing, assembly, testing, and finished-goods inventory.
If a correction becomes necessary later, the work may have to be repeated across a much larger quantity.
The deadline is real. So is the unresolved risk.
Production pressure rarely comes from one direction.
The buyer may be working toward a marketplace launch, a retail commitment, or a seasonal sales period. The manufacturer may be coordinating suppliers, production capacity, and an agreed delivery date.
Both sides may have legitimate commercial reasons to move quickly.
The problem begins when the pressure to proceed replaces the evidence needed to make the decision.
Suppose a key function has not been verified on the intended production configuration. Or a component substitution is still awaiting an impact assessment.
Starting production may be possible in a physical sense, but the decision carries unresolved technical or commercial risk.
A responsible manufacturer should not quietly treat that risk as resolved simply because the schedule is tight.
If its engineering or production team identifies a material concern, it should explain the issue, its potential implications, and the information or decision needed to address it.
The buyer also has responsibilities: providing timely decisions, confirming requirements, and understanding the consequences of changes to the agreed scope or schedule.
Neither side benefits from pretending that the deadline makes an unresolved issue disappear.
The appropriate verification plan depends on the product design, risk profile, destination market, and project agreement. There is no single universal test list for every smart pet product.
| Product type | Possible areas to verify |
|---|---|
| Automatic pet feeders | Dispensing performance, relevant moving parts, sensor logic, power behavior, and connectivity where applicable |
| Automatic litter boxes | Cleaning movement, safety-related sensing, operating logic, and continuous operation where required |
| Pet water fountains | Pump operation, water flow, filter compatibility, power behavior, and operating stability |
These are possible areas of consideration, not mandatory tests for every product.
The test conditions, acceptance limits, sample quantities, and duration should be established for the actual design and intended use.
Depending on the project, the evidence may include functional verification, relevant reliability tests, firmware checks, or a pilot production run.
A pilot run can help reveal whether the intended assembly and control methods work under production conditions.
It does not automatically prove that every risk has been eliminated or that every later batch will perform identically.
Before testing begins, the team should agree on three things:
- What is this test intended to establish?
- What result counts as acceptable?
- What happens if the result does not meet the requirement?
That last question is often overlooked. A test plan is incomplete if the team knows how to run the test but has not agreed how to respond to a failure.
Mistake #4: Assuming Final Inspection Can Catch Every Problem
Final inspection matters. It is also frequently asked to prove more than it can reasonably establish.
A finished product can look correct and pass a short functional check while still having a problem that appears only under a particular operating condition, after repeated use, or across a different production batch.
The answer is not to abandon inspection. It is to understand what each inspection activity can—and cannot—prove.
Consider three situations:
- A product passes its appearance check, but a sensor behaves inconsistently under a condition the inspection does not reproduce.
- A device completes a single functional test, but the test does not establish performance over the longer operating cycle relevant to its intended use.
- One unit passes inspection, while a process variation affects units produced later in the batch.
In each case, the inspection may have been performed correctly for its defined purpose. The limitation may lie in the test scope, the production controls, or the conclusion someone draws from the result.
This is why “QC passed” is not a complete explanation. The buyer needs to understand what was checked, under which conditions, against what criteria, and with what result.
Research on manufacturing inspection strategies examines the relationship between inspection decisions and quality costs. The same principle applies to pre-shipment inspection.
It can provide useful evidence about the inspected goods against the agreed inspection criteria and sampling plan. It should not be represented as proof that every unit is defect-free, that every long-term reliability risk has been resolved, or that the entire production process is under control.
Prevention addresses risks before they become defects.
- Depending on the product, this may involve design review, clearer specifications, appropriate component selection, process planning, and defining how important characteristics will be verified.
In-process control looks for deviations while manufacturing is underway.
- Checks may focus on assembly conditions, critical dimensions, component installation, functional results, or other characteristics that need monitoring.
Final inspection evaluates completed goods against agreed release requirements.
- This may include appearance, dimensions, functional checks, labeling, packaging, and other relevant criteria.
Pre-shipment inspection can add another check before goods leave the factory, within its agreed scope.
None of these activities makes the others unnecessary.
When a defect is found, the response may need to go beyond removing the affected unit.
If the underlying cause could affect other products, the team may need to identify the cause, assess the possible scope, correct the process, and verify that the corrective action is effective.
The appropriate response depends on the problem and the agreed quality procedures.
For buyers, the useful questions are:
- What characteristics were inspected?
- Which acceptance criteria were applied?
- What sampling or test method was used?
- What happens when a result is unacceptable?
- How are affected products or batches identified when further investigation is necessary?
A photograph of an inspection station may show that equipment exists. It does not, by itself, demonstrate that an effective quality control is operating.
For buyers assessing a manufacturer’s quality controls, it may be useful to look beyond the final inspection report and understand how quality control works across Chinese OEM manufacturing.
The distinction matters because a final inspection can reveal certain defects in the inspected goods, while effective process controls address other risks before they reach the finished-product stage.
Mistake #5: Ignoring the Cost of Changes
A product change is not automatically a mistake.
It may be necessary to resolve an engineering issue, improve manufacturability, respond to a supply constraint, or meet a confirmed requirement.
The costly mistake is treating every change as though it has the same consequences regardless of when it occurs.
A change made before materials are purchased may be handled differently from the same change after components have been ordered.
A design adjustment before production may have a different impact from one introduced after assembly has begun.
A packaging revision may affect existing materials, labels, instructions, or shipment arrangements.
The relevant question is not simply how difficult the design work appears. It is how the change affects the project’s current state.
A practical change-impact review may need to consider:
- New material or component costs.
- Existing materials that may become unusable.
- Additional engineering and verification work.
- Potential rework or changes to production setup.
- Assembly instructions and other manufacturing documents.
- Packaging, labeling, or compliance implications.
- The expected effect on the delivery schedule.
A study in Industrial Engineering Journal examines the impact of product design changes on production planning, considering time, cost, and quality in an aviation-parts manufacturing case.
The study provides context for evaluating design changes in their manufacturing setting. It is not a universal formula for predicting the cost of every OEM revision.
There is no reliable cost multiplier that applies to every late change.
A minor cosmetic adjustment and a change to a core mechanism are not comparable simply because both occur late in development.
The team should assess the actual consequences before approving the change.
A low quotation can look attractive when procurement is comparing suppliers. But unit price alone does not describe every cost that may arise during execution.
Rework, repeated testing, unused materials, additional inspection, schedule adjustments, and after-sales problems can all affect the broader economics of an OEM project.
For a buyer, the consequences may extend beyond the factory invoice.
A delayed launch may disrupt inventory planning or a retail commitment. A quality problem may create customer-service work, returns, replacement shipments, or reputational pressure.
These are possible consequences, not inevitable outcomes of every production issue.
Responsibility matters, too.
If the buyer changes approved requirements after materials have been ordered, the resulting costs may reasonably depend on the agreed change terms and the actual impact.
If the manufacturer implements an unapproved substitution or fails to communicate a material production risk, those consequences should not simply be attributed to the buyer.
Both parties should distinguish the cost of a requested change from the cost of an avoidable execution failure.
This is why a sound OEM quotation and project agreement should make relevant assumptions visible, establish how changes are approved, and explain how additional costs or schedule effects will be communicated.
A competitive unit price does not necessarily mean a lower total project cost.
Buyers comparing OEM quotations may benefit from examining the full cost of smart pet product manufacturing, including the assumptions behind pricing and the additional costs that can arise from engineering changes, production requirements, and import arrangements.
This broader view can make supplier quotations easier to compare on a like-for-like basis.
Mistake #6: Leaving Responsibility Unclear
An engineering problem does not become manageable simply because everyone has received the same email.
When an issue appears, the team needs to know who evaluates it, who makes the relevant decision, who communicates the result, and who ensures that the agreed action is completed.
Without that clarity, small problems can remain open while different people assume someone else is handling them.
For a typical OEM project, the parties should establish:
- Who can propose a product or component change?
- Who evaluates its engineering and manufacturing impact?
- Who reviews test results against the agreed criteria?
- Who confirms that a required correction has been completed?
- Who can approve production release under the project agreement?
- Where is the final decision recorded?
A small project does not need to operate like a large corporate development program. A concise written record and clearly assigned owners may be sufficient for many decisions.
But a critical decision should not depend entirely on an informal conversation that different people remember differently.
Technical evaluation and commercial approval also need to be distinguished.
An engineer may assess whether a change is technically acceptable, while the buyer may need to approve a change to the agreed product specification or cost. The exact division of authority depends on the contract and project arrangement.
The objective is not to transfer every decision to one side. It is to make sure the right person makes each decision with the relevant information.
Imagine that a component becomes unavailable shortly before production.
The manufacturer identifies an alternative, but the potential effect on product performance or verification is not explained clearly.
The buyer later discovers that the replacement differs from the approved configuration.
The supply problem itself may have been unavoidable. The failure to assess or communicate a consequential change may not have been.
The team may now need to review compatibility, agree on additional verification, update documents, and revise the production schedule.
Effective manufacturing project management makes issues visible early enough for the parties to act. It identifies the problem, its likely implications, the decision required, the responsible person, and the next review point.
The manufacturer’s responsibility also does not disappear because the buyer approved something. Approval must be understood in context: what information was disclosed, what decision was requested, and which responsibilities each party accepted.
A buyer cannot reasonably expect a manufacturer to infer every unstated preference. Equally, a manufacturer should not treat a buyer’s approval as permission to conceal a known technical risk or ignore an unresolved requirement within its own area of responsibility.
For Petrust, the relevant standard is not that every problem can be prevented. It is that material manufacturing risks should be communicated, decisions should be handled under the agreed approval authority, and issues assigned to the manufacturing team should receive appropriate follow-through.
That is a responsibility principle, not a claim that every project uses an identical formal workflow. Any claim about a specific Petrust procedure should be supported by the practices and records that genuinely exist.
Mistake #7: Starting Production With Requirements Nobody Has Defined Properly
A buyer says the product should be quiet, reliable, easy to clean, or accurate.
The manufacturer agrees.
Everyone believes the requirement has been understood.
But what does “quiet” mean under the intended operating conditions? What level of performance counts as accurate? Which functions must be tested, and what result would make the product unacceptable?
These are not minor wording issues. They determine whether the product can be evaluated against a shared standard.
Consider three common expectations:
- “The feeder should dispense accurately.”
- “The litter box should operate quietly.”
- “The fountain should maintain stable water flow.”
Each statement describes a meaningful product goal. None necessarily defines a complete acceptance test.
For the feeder, the requirement might involve portion performance under specified conditions.
For the litter box, noise evaluation may require an agreed measurement method and operating condition.
For the fountain, flow performance may depend on the product configuration and test setup.
The actual requirements must be established for the product and intended use. They should not be invented by a sales representative—or by an article writer—without an engineering basis.
A practical approach has three parts.
- Define. Translate important expectations into specifications, test conditions, or other acceptance criteria appropriate to the product. If a requirement cannot be measured directly, define an appropriate evaluation method.
- Confirm. Make sure both parties agree on what the requirement means, how it will be assessed, and which product configuration it applies to.
- Record. Keep the approved requirement and relevant changes identifiable so development, production, and inspection teams work from the same basis.
Not every customer preference needs a complicated technical specification.
The priority is to identify the expectations that materially affect product performance, safety, quality, or commercial acceptance and make them sufficiently clear to verify.
This also creates a fairer basis for resolving disputes.
If a product fails an agreed criterion, the team can investigate the deviation.
If the parties never agreed on the criterion, they may first need to clarify what was required before deciding whether the product is nonconforming or what corrective action is appropriate.
The lesson is not that buyers must become engineers. It is that important expectations need to be translated into something the manufacturer can build to and both parties can evaluate.
When Should an OEM Project Stop Before Production?
Not every unresolved issue should stop an entire project. But not every open issue can safely be carried forward, either.
A useful practical decision rule is to separate unresolved issues into three categories.
Apply it in the context of the product’s risks, applicable requirements, and project agreement; it is not a substitute for product-specific engineering judgment or a claim that every manufacturer follows the same formal procedure.
Pause when a critical safety requirement, a change affecting core functionality, or a verification explicitly required before release remains unresolved.
Do not treat a deadline, a purchase order, or an approved sample as a technical reason to bypass the missing evidence.
The next step is to identify what remains unverified, who must resolve it, and what evidence is required before the affected decision can be reconsidered.
Some outstanding issues may affect cost, appearance, schedule, or other agreed requirements without automatically invalidating every production decision.
Before proceeding, establish the actual impact, the responsible owner, the proposed treatment, and the approvals required under the project agreement. Record any accepted deviation and its conditions where appropriate.
Do not casually reclassify a critical requirement as a minor issue simply to preserve the schedule.
Proceed when the applicable requirements, necessary verification, and relevant approvals have been satisfied, and remaining issues do not undermine the basis for the release decision.
The decision should reflect what has actually been established—not merely what the team expects will probably be true.
The key question is not “Can we start production?” It is “What evidence makes this production decision defensible?”
How Petrust Approaches Manufacturing Decisions
In OEM manufacturing, it is easy to say that specifications should be confirmed, changes should be controlled, and quality should be checked.
The real work begins when a project encounters a change, a tight deadline, or a problem that was not obvious during development.
That is where manufacturing experience matters.
Petrust works on smart pet product development and manufacturing, so these decisions are not just items on a buyer’s checklist. They are part of getting a product from an approved design to a production run that meets the agreed requirements.
Not every project needs the same level of documentation or the same verification steps. A change to appearance is not the same as a change to a core function.
A development sample is not the same as a production batch. The important thing is to understand what has changed, what the change might affect, and what needs to be checked before moving forward.
Keep the Product Version Clear
Problems can start when the buyer, engineering team, and production team are no longer working from the same product definition.
Specifications, drawings, the BOM, relevant firmware versions, and test results can all help clarify what has been agreed. Which records matter most depends on the product and the stage of the project.
The aim is not to create documents just to make a process look complete. It is to make sure the team can identify the configuration being developed or manufactured, understand the requirements that apply to it, and recognize when something has changed.
Don't Treat Every Change the Same Way
Some changes are straightforward. Others can affect how a product fits together, operates, or performs under actual use conditions.
A component replacement, for example, may be easy to arrange from a purchasing perspective but still raise engineering questions.
Depending on the part and its role in the product, the team may need to review compatibility, assembly, functional performance, or existing test results before deciding what further checks are necessary.
The level of review should fit the change—not every revision needs an elaborate process, but a change that affects an important product requirement should not be treated as a simple parts swap.
That is the practical distinction between making a change and understanding its consequences.
When a Problem Appears, Work Out What It Affects
Manufacturing issues do not all have the same cause or require the same response.
Sometimes the problem is limited to a particular unit. Sometimes it raises a wider question about a component, an assembly step, or the consistency of a batch.
The first task is to understand what has happened and how far the issue may extend.
From there, the team can determine what needs further checking, what action is appropriate, and who needs to make or approve the next decision.
Clear communication matters here.
If an issue could affect an agreed requirement, production timing, or the acceptability of the goods, it needs to be discussed in time for the people involved to respond. A deadline may affect the available options, but it does not change what a test result actually tells us.
This is also where responsibility needs to be clear. Buyers need to confirm the requirements and decisions that fall to them.
Manufacturers need to address the engineering and production matters within their remit.
When a problem crosses those boundaries, the next step should be based on the facts, the project agreement, and the impact of the issue—not on assumptions about who is automatically at fault.
That is how we look at manufacturing responsibility at Petrust: understand the product, assess the issue in context, and make the next decision with the information available.
The aim is not to pretend that every project runs without complications. It is to deal with the important ones before they become larger production or delivery problems.
Before You Approve the Next Production Run
Use these questions as a project discussion aid before releasing an OEM order into mass production.
This is not a certification, a substitute for product-specific testing, or a formal production approval.
Approved product configuration
□ Have the relevant specifications, drawings, and critical product versions been identified and confirmed?
□ Does the intended production configuration correspond to the configuration that was evaluated?
Components and materials
□ Are the intended components and materials consistent with the agreed production configuration?
□ Have relevant differences or substitutions been reviewed?
Required verification
□ Have the required tests been completed and reviewed against the agreed criteria?
□ Are any important results still pending or inconclusive?
Open issues
□ Does each unresolved issue have a clear owner and next action?
□ Could any open issue affect a critical requirement or invalidate the release decision?
Engineering changes
□ Have relevant changes been evaluated and approved under the agreed decision process?
□ Have affected specifications, production instructions, and verification activities been addressed where necessary?
Production release
□ Is the decision to proceed supported by the relevant evidence and approvals?
□ Can the project team identify the basis for that decision later?
A checked box is meaningful only if the underlying condition is supported by evidence.
If a required test has not been completed, marking it complete because the test is scheduled defeats the purpose of the review.
Likewise, not every open issue requires the entire project to stop.
The team should determine whether the outstanding item can be carried forward under clearly defined conditions or whether it affects a requirement that must be resolved first.
If key specifications remain unclear, necessary verification is incomplete, or a significant production risk has not been appropriately addressed, the correct next step may be to resolve the issue before proceeding—not to push the schedule forward and hope it disappears.
A reliable OEM project is not one where nothing ever changes. It is one where changes are evaluated, problems are surfaced early, and production does not move forward on assumptions alone.
Better OEM Decisions Start Before the Production Line
The most damaging common OEM manufacturing mistakes are not always dramatic.
Sometimes they begin with an approved sample whose production configuration has not been fully established.
Sometimes a replacement component is accepted without checking which earlier test results still apply.
Sometimes final inspection is expected to prove more than its scope allows. Sometimes a launch deadline becomes the reason an unresolved question is treated as settled.
Buyers influence the outcome through the requirements they provide, the decisions they approve, and the changes they introduce.
Manufacturers influence it through engineering judgment, production controls, verification, communication, and their response when something goes wrong.
Neither side benefits when responsibility is left ambiguous.
For Petrust, manufacturing responsibility means being prepared to explain how product requirements, engineering decisions, and production conditions are handled—and to support specific claims with genuine evidence where available.
It also means recognizing the limits of what a sample, a test, an inspection, or a document can establish.
The objective is not to promise that every OEM project will run without problems.
It is to make important decisions with better evidence, address risks before they spread, and establish clear responsibility for moving from an approved sample to repeatable production.
If you are still working out the product requirements or the path from development to mass production, start by understanding which decisions need to be resolved at each stage.
Share your product type, current development stage, key functions, estimated order quantity, and target production timeline. Petrust can discuss the requirements, identify the information needed to assess the project, and determine whether it fits our manufacturing capabilities.
